Thursday, 21 April 2011

110420 Site Visit


Classroom block- scaffold struck- window head linings installed


Praeposters teapoint installed


Laminate required to end, worktop over fridge damaged, corner unit not as drawing + requires end panel as detail CL110


Conflict between lighting and acoustic panels- HCL to redo/ make good- CL 030 rev C9/ sk 608


Make good to bulkhead Praeposters- HCL


Making good required around some TEK vent covers/ CVA/ HCL


Dome-headed pig-nose fixings to cubicles


Washers not agreed


Making good around TEK vent covers req'd


CL stair capping added


Capping join detail


Harbo end panel/ cap junction


Careers library installed- WISA multiwall


Otway print room pocket door installed


Assembly hall acoustic panels installed


Assembly hall minstrels lighting to wash stairs


Assembly stair lining nears completion


Stage lighting installation AS ceiling underway


Modifications required to emergency lighting- subframe- ref AS 140

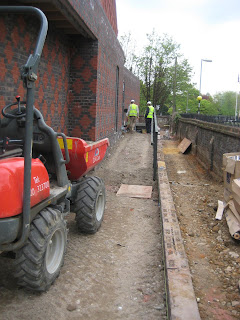

Repointing to Ingrave Road wall commenced


AS plinth/ landscape underway


Pattressing req'd for handrail- HRW/ CVA to confirm


Glass replacement outstanding- AS green room



AS profiles to overhang- awaiting alcobond panelling/ subframe


mastic still required- head lining/ TEK vent junction


CL elevation


CL view from courtyard


Otway stair- awaiting decs


Otway GFL


Otway teapoint cupboards- HRW/ CVA to advise regarding hanging/ fixing/ weight


CVA/ HRW to advise regarding fixing/ pattresses to minstrels gallery handrails


Praeposters court paving laid


CL stair 2


Assembly/ Otway overview- topsoil for landscape


Overview of Sixth Form Centre


Canopy installed adjacent Queens


HCL to fosroc repair cill to Queens

Tuesday, 19 April 2011

110414 Site Visit


Assembly Hall overview- sedum blanket installed


Hard landscape/ soft border underway to classroom block


Trees felled to Ingrave Road


Otway/ Assembly hard landscape underway adjacent green room/ lobby


Acoustic panels installed top floor classrooms


Assembly stair panelling underway


Otway timber floor laid


Water fountains installed- tiling required- CVA to confirm


CL stair acoustic panels installed 2FL ceilings


Classroom 11- awaiting vertical acoustic panelling


Stair battening- awaiting acoustic panelling- classroom stairs


CL link- Praesposters court underway


TEK internal grille- RAL 9010 as wall


Security box dummy only- to be removed (not on approved drawings)


Handrail/ ramp underway to Assembly hall adjacent Ingrave Road


Ditto


Praeposters Court underway


metal profile reveals/ head flashing underway to GL A CL block


Deep reveal head flashing w/ drip- CL block


Shallow reveal head flashing w/ drip- CL block


Assembly Hall overview


Assembly hall stair cladding underway


Ditto


Curtain pocket formed AS hall


Closing piece required between fineline glazing and trench heating- now instructed


Bleachers installed


Otway tiles- to be replaced where damaged


Bleacher overview from Minstrel's gallery
