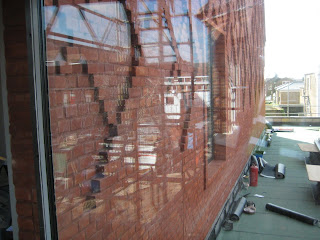

Friday, 25 March 2011

110324 Site Visit


Green room glazing underway


Stair 1 lining underway


Top floor classroom decoration


Closing piece to curtain wall, classroom link GFL


Otway teapoint joinery complete


lining details forwarded to HCL for rooflight


Fixed joinery underway to 1fl careers library- CL link


Otway pastoral offices nearing completion 1FL


Latchway system underway to AS plinth roof


1FL Assembly link trench heating installed


CVA to confirm updated setting out around RWP.AS.08


AS stair glazing complete- awaiting linings


AS link


Classroom block- scaffold struck to link


AS GFL glazing to plinth nearing completion


Acoustic panel housing installed AS high level hall


AS link external- awaiting soffit panels


Fineline/ trench heating


AS link overview


Cracks over GL C CL.EW.00.14- monitor- HCL to repoint


Ditto

Tuesday, 22 March 2011

110321 Site Visit


Ingrave Road overview


Assembly Hall- windows installed


Otway- teapoint nearing completion


Otway scaffold struck


Ditto


Classroom link- 'no architrave' detail- agreed on site

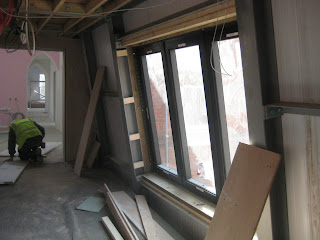

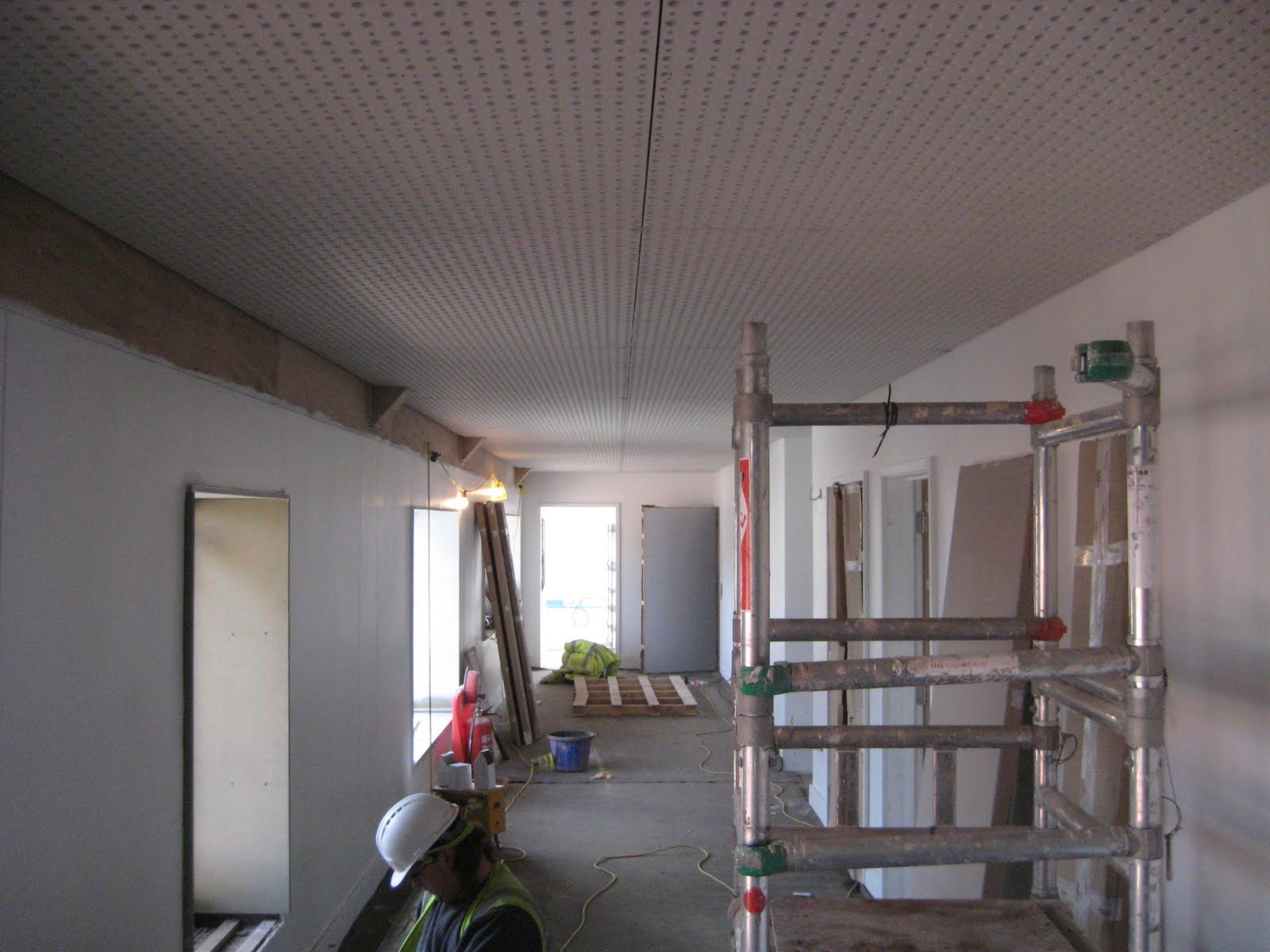

2nd floor doors installation underway to classroom block


Revised classroom gambrel roof detail underway


Ditto


Tiling to link complete- issue with coping/ ridge tile- HCL to clarify/ CVA to advise


Fineline installation nearing completion


View over green roof/ Ingrave Road


View back to Otway through first floor link


View along screen- fritting omitted to last two panes in error- CVA to advise


first floor link glazing installed


Fineline windows installed ground floor assembly hall


2nd floor corridor classroom


Blue coping to trapezoid rooflight


Assembly acoustic panels on site awaiting installation

Friday, 18 March 2011

100317 Site Visit


Ingrave Road- overview with scaffold struck


Assembly Hall- windows installed 1st flr


AS- Fineline glazing installation underway to courtyard


CL link- curtain walling installation nearing completion


discrepancy to head/ cill- HCL to liaise with SecCo regarding interface with soffitt panels


Awaiting soffitt panel to reveal for completion- classroom north elevation


Classroom block-Library square overview


Assembly link- awaiting Fineline glass installation


Assembly interior- acoustic reflector panel installation nearing completion


CL stairs- tiling underway with contrasting nosing/ riser detail


Ditto


Classroom 12 lining complete- awaiting joinery


Classroom 16- window reveal complete


Classroom 16 - ceiling awaiting bead/ skim


Joinery scalloped pen rest detail to whiteboards


Overview


CL roof- adjustment required to trapezoid rooflight tiling perimeter


CL gambrel- detail not as drawn- to be reworked

Ditto- flashing girth to be greater/ no intermediate tile to transition


OT- Sealant to 1fl windows complete except OT.EW.01.08


Fineline rail overlooking plinth roof


Sleeve around hot pipes installed


Gulley installed to AS plinth


CVA/ HRW to forward guarding details- AS mezzanine- RHS


CVA/ HRW to forward guarding details- AS mezzanine- LHS


Central aisle cavity- for gate- CVA/ HRW to forward details


CVA to forward handrail details AS mezzanine


TEK vent to green room installed


External view- TEK green room vent


Glazing underway - AS green room


AS panelling frame nears completion


AS ceiling


AS Reflectors


AS court overview


HTP sample client supply locker delivered to staff room
WISA to match other joinery
