Friday, 24 September 2010
100923 Site Visit
Otway arch- still awaiting final Lambs drawings- no progress
Mortar pointing samples- on inconsistent/ stock bricks- additional samples to be carried out
lead/ gable detail underway Otway
Arch OT.01.15 still unpropped following damage
New slates underway
Valley detail underway
Insect mesh detail

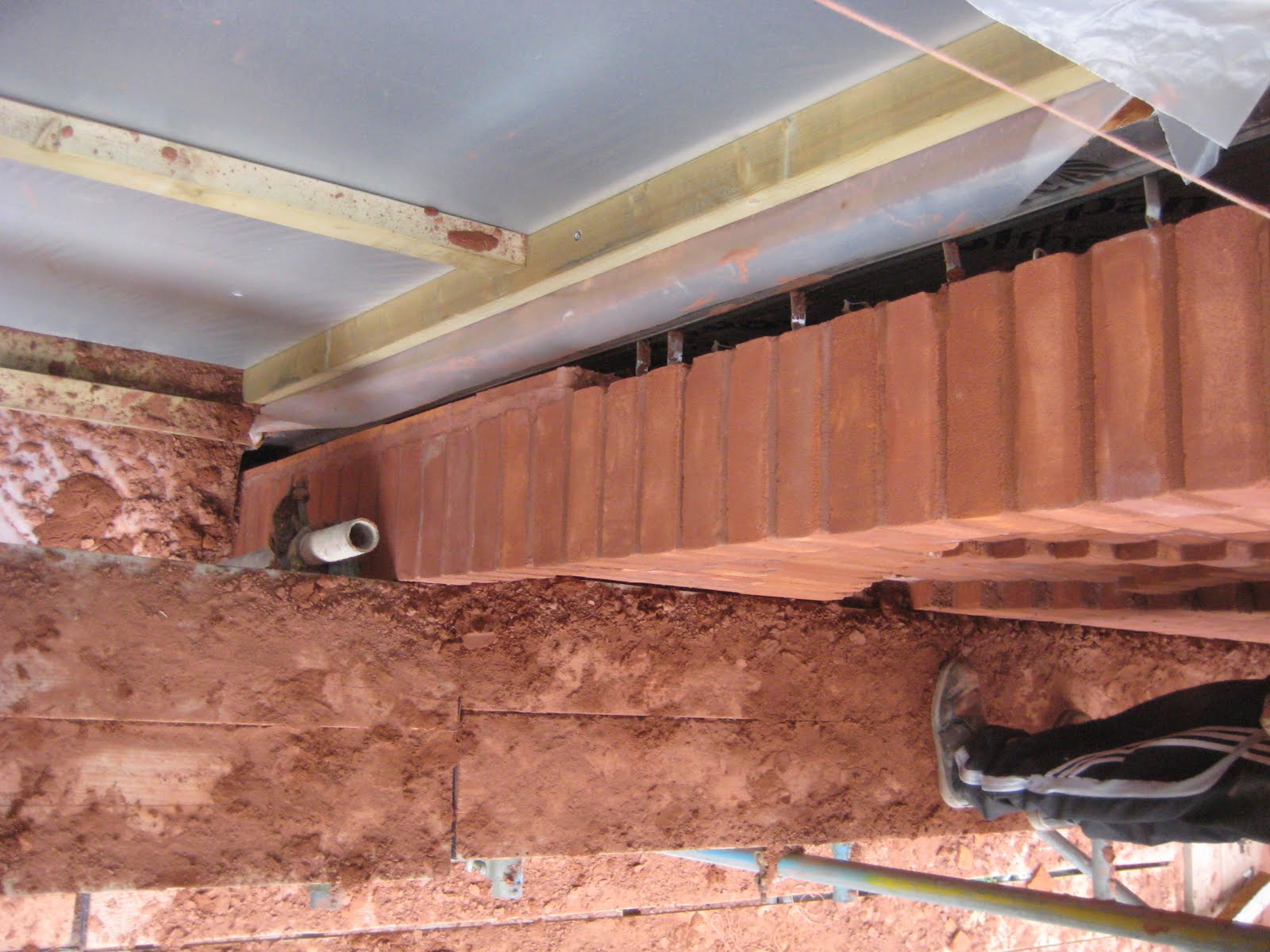

First fix, secondary floor joists 1st floor Otway
First fix/ penetrations High level ground floor Otway
Different block specification- not Plasmor- HCL to confirm
GL A/7 reveal detail to be updated due to TEK cill detail/ movement joint
Ditto CL.EW.02.04
Ditto CL.EW.02.07
Raked cut to GL 4 high level
Link steelwork
Valley gutter installation underway classroom block
Remedial works to ties now undertaken
TEK to clarify strategy for Attenuated vent installation procedure
High level obstruction to attenuated vents 2nd floor- HCL to clarify fixing to underside of ringbeam
rods to be trimmed to allow acceptable tolerance for TEK vent
Openings for chimneys required high level ground floor GL B and C/ 1
CVA to confirm brick slips to concrete chimney base face
CVA to forward canopy detail, HRW to update structural connection
Chimney tie remedials underway
Ditto
Engineering brick penetrations- HCL to confirm possible remedial works to amend with FOSROC
Issue with high level steelwork to assembly mezzanine/ build up/ Vales works
Assembly hall ceiling 1st layer under installation
Classroom/ Otway overview
Assembly hall 1st floor lintels on site- HCL to forward brick slip details/ specs for comment
DGT expanding foam detail to valleys
Brick reveals underway GL 18 Assembly
GDT profile to be added to all locations where remedial works are underway
BJR to corners, GL Q/18
'V' detail GL Q/16 underway

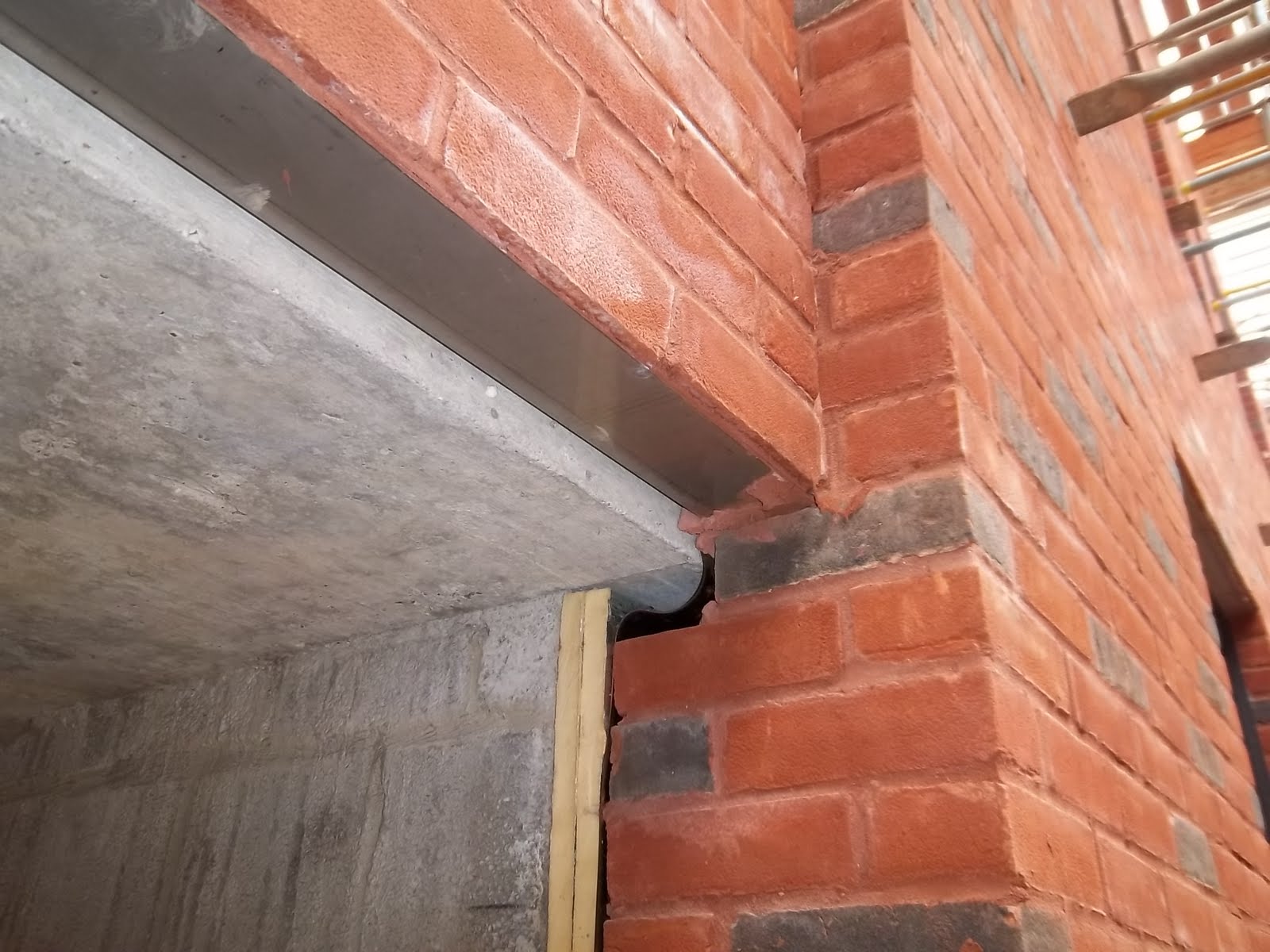

High level corner nearing completion GL Q/14
Friday, 17 September 2010
100916 Site Visit
Overview from Ingrave Road
Classroom block gable brickwork underway to courtyard
Fixings for secondary grid- assembly hall
Area for remaining bricks lift to assembly- to commence shortly
DGT profiles adjacent gutters to be fitted- assembly roof
GL Q/14- bricks marked up to corner for amendments following previous comments
GL 18 brick reveals assembly hall
Corner underway GL Q/18
Latchway system installed to Bauder roof assembly hall
Assembly rooflights awaiting installation- main roof
Rooflight detail (to be rotated 180ยบ before installation)
Otway gable end (new facing brick) revealed
Arch repairs first floor Otway revealed
Lead detail against rebuilt chimney Otway
Valleys introduced Otway
Arch repair imminent- condition worsened
Bed joint reinforcement installed gable end classroom- courtyard
Block to be cut GL K/20
Protection to door linings classroom block
Link steel installed
High level raked steel angle trim
Possible service clash 1st floor classroom- CVA to advise regarding clerestory set out
Joinery schedule to be updated re: clerestory lights
TEK vent/ reveal
Concrete upstand detail- acoustic panel/ interface/ bead detail to be reviewed
Concrete remedials underway to chimney base classroom
Assembly overview- plinth
timber structure for rooflights underway
Pattern brick to chimneys internally- classroom block
DGT gutter installation underway- classroom block
Ties- cracking to ringbeam GL C
TSI remedials to trapezoid rooflight area
further tolerance req'd to top steel- HCL to fwd fixing detail option for HRW review
ditto
Floor joists first floor Otway
Link steelwork classroom/ Otway
Stanchion/ recess infill- CVA to confirm detail re: LAC support
Gutter for classroom on site
tolerance for linings to be reviewed
Link steel connection
Main chimney brickwork/ ringbeam interface
Chimney brickwork- movement joint
Link overview
Repair to corner underway- Queens
