Friday, 10 September 2010

100906+09 Site Visit

TEK Attenuated Vents


Fixings- allen key required- as latest comments


Gland required for penetration of cable into unit


Scrating of cill during installation- TEK to resolve setting out/ sizing/ packing of cill and units accordingly


back of cill in incorrect position


Cill not as CVA detail


Acoustic insulation- TEK to forward thermal value


PPC poor finish to external grilles- TEK to advise/ address


Alignment to cill tray and unit to be addressed

Assembly Hall

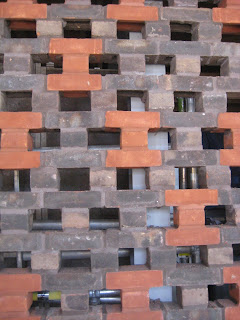

Relief pattern brickwork GL Q/14 with Ibstock special now installed


187mm solids not aligned (impinging on cavity on left hand side)- to be relaid- Hutton to address


Cavity less than 50mm- Hutton to address


Assembly Hall North Elevation overview


GL Q/14 overview with wrapping relief pattern


Along GL K to plinth brickwork


Hole in DPC forming cavity tray GL K/20 corner 1st floor- to be addressed


Screed too high AS.ED.00.02- HUT to amend levels/ openings for NACO grilles if maintained


Lightning protection to plinth brickwork


DGT gutter remedials underway


CVA to instruct painting of windposts behind hit and miss brickwork to plinth/ plant

Otway House


HUT to order different sand for final mortar samples Otway


Ditto


HRW to advise regarding steel conflict to assembly link


Adjacent Otway awaiting link steelwork

Classroom Block


CVA to instruct airbricks to ventilate sealed cavities


CVA to instruct timber stud to form internal lining


HUT to forward remedial proposals for discrepancies in screed- Stair 2 GFL


Window heads incorrect to corridor windows (only required to deep reveals)


1st fix electrical Praes


Brickwork not protected prior to cutting of Ringbeam/ remedials- Hutton to advise regarding cleaning


Awaiting link steels


Classroom rooflights delivered


Classroom courtyard overview


Classroom roof steelwork overview

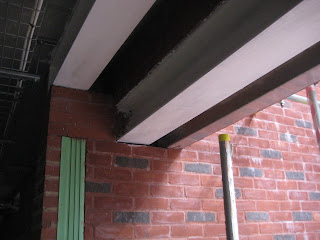

Chimney steelwork


Roof steelwork above lift shaft


Classroom brick overview- Ingrave Road


2nd floor corridor


Big chimney ringbeam- insulation/ vertical DPC required- CVA to instruct


Conflict between revised ringbeam and roof plane- HRW to advise. CVA marked up cut away required on site


Ditto


Pattern chimney brickwork- C.06-7


Marking out on facing brickwork- HUT to address


Packing out of door linings excessive- HUT to address
