Thursday, 28 October 2010

101028 Site Visit

Status of brickwork to Assembly Hall. Hutton confirm that setting out issues have been addressed.

Plastering underway on Classroom ground floor

Condensation to omnia noted on Ground floor classroom ceilings



Water ingress from above onto newly plastered classroom (ground floor)

Vertical cladding and cavity wall work to link not yet underway.

Issue with pipework in front of clerestory

Run off from roof works along Ingrave road elevation of Classroom Block. Hutton have been advised and will clean.

Triple arch brickwork has arrived on site ready for installation.

Fireline to Otway Ground floor ceiling: CVA to confirm if skimming is required above suspended ceiling.

Otway ceiling linings under way, additional layer of plasterboard required. Insulated lining around rooflights will need to be cut back to achieve splayed reveals with final layer of plasterboard.

Otway roofing complete, awaiting rainwater goods.

Vale Interiors have raised a question about the method of hanging the lowered ceiling off the raked structure, particularly the fixing to the primary steel.

Hutton to ask how internal wall lining & build-up above long opening to Assembly is supported.

Hutton to ask how floor joists of plenum are picked up at Assembly external wall

Friday, 22 October 2010

101021 Site Visit


Assembly ductwork underway


sequence


ditto


ditto





top hat sections installed GL Q- awaiting lining


Plaster to GFL classrooms- w/ termination bead and contraction joint completed


1st fix elec for lighting/ plastering to WCs GFL classroom


Containment query GFL classroom s- CVA/ HCL to liaise


expamet to blockwork where changes in substrate


Fireline to GFL Otway


ditto- + 1st fix elec


prep for light fitting to GFL stair 1


Otway dry-fix ridge tile- mortar poor finish


ditto


MFLLP to confirm omission of 1 No. light fitting stair 1 1st floor


TEK vent/ grille installed- protective galv cill


ditto


Fire stopping to doorways- classroom block


Classroom block gable end overview


Brickwork damaged by scaffold GL A


ditto


TEK vent external view


GL A overview external or openings


GLQ/18- additional support req'd- CVA to instruct/ advise


Top hat sections fixed GL Q internal


ditto


Brickwork GL 14


Brickwork GL Q external

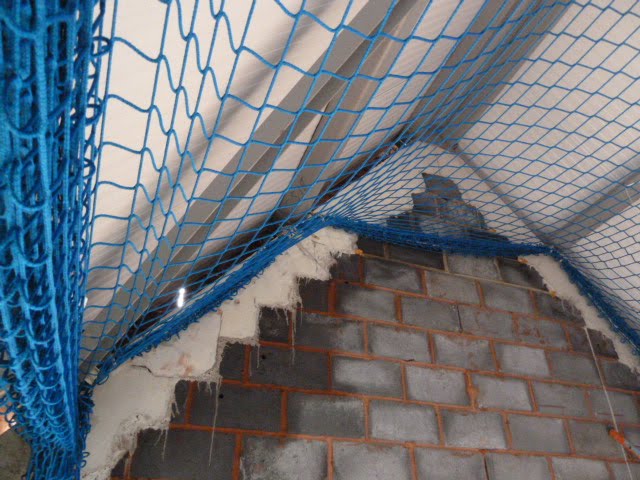

Gables- geometry high level


Acoustic/ stopping required Assembly plenum


Additional bolts required to steel connection


Intumescent paint req'd to classroom link


CL.01.18 internal reveal too low- HCL to advise

Friday, 15 October 2010

101014 Site Visit


Otway timber paint sample- for client review


Rooflights installed high level- actuator/ cheek detail to be revised- CVA


Additional minor brickwork repairs to be clarified- previously obscured by Scaffold

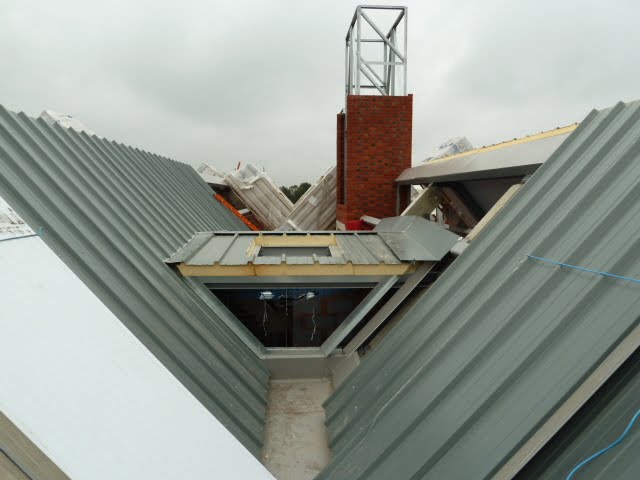

Chimney in progress


DGT gulley- remedial works required to parapet and interface with gutter GL D



Classroom valley- DGT Kingspan panels installed to lift overrun


Kerb detail


kerb detail completed- sealant detail to be reviewed- CVA/ HCL


Damage to eaves panels- crown/ overlap poorly fitted- HCL to advise


Holes to panel- HCL to advise of remedial work


ditto


Gutter GL4


Gutter GL 4/D


Containment GL 2/3 to top floor classroom- CVA to instruct surface mounted where clashing with upstand- additional joinery plinth to be added below dado- CVA to instruct


Link deck installed


Edge beads added and bonding coat commenced- Praepostors


Insulation to be fitted between ringbeam and roof panel to maintain cavity


Assembly gable brickwork progressing


Ditto


Classroom acoustic vents carcassing/ cills installed GFL


Screed laid to perimeter storage Assembly hall


Conflict to clerestory 1FL classroom block


review chasing of 1 No. light to Stair 1, 1-2FL


Interactive whiteboard spec. updated to pictured model with ancillary speakers and amp...


.... from previous model- CVA to review impact of changes proposed to build/ coordination


secondary grid installation underway


Internal metsec installation underway- note recesses formed for acoustic panels


Ditto
