Friday, 26 November 2010
101125 Site Visit
Assembly Fireborn blue capping installed to plinth -special corner
ditto
Classroom lift installation underway
Internal brick exposed- but not ibstock- HCL to advise- not as CVA detail
Recessed now skimmed- awaiting wall lights
Light greypointing mortar currently being used to repoint (dabbed in centre) differ from Otway conservation officer approved mortar sample 6:1:1- HCL to advise
2nd floor plant trough underway- CL

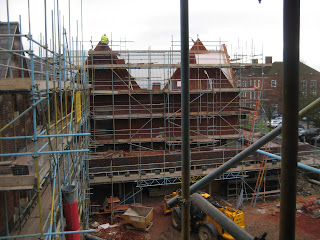

Assembly gables in brick nearing completion
CL stairwell rooflight- main stair
CVA to instruct dryline fillet- to be coordinated with 2fl joinery- HCL to advise HTP- to form part of CVA comments on joinery
Containment to class stairs to be shallower bend to allow fixing of acoustic panels to u/side of stair
CVA to forward detail for lining to rooflight/ wall junction
Internal chimney underway classroom 11

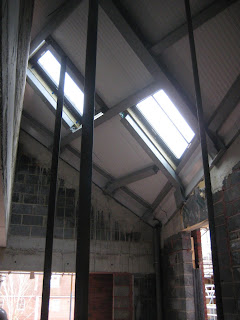

trapezoid rooflight installed classroom 11
block awaiting acoustic seal- classroom block 1fl
patterned chimney complete classroom 8
Block/ prop detail to be resolved- GL C/7
TEK vents 1fl- awaiting cills- promised Mon 22 Nov
CVA to check detail of support with HRW
Brickwork badly stained, cill mods required, ringbeam mods required GL 4
GL 4 overview.
Setting out of brick gable geometry GL D to be clarified with HCL
Otway loft linings nearing completion
Otway stair lighting underway
Otway elec containment GFL underway- CVA to check levels/ items against drawings
Roof scape overview

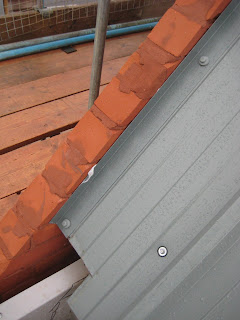

DGT gutter to be modified to corner
DGT flashing closer piece installed
Awaiting adjusted gothic arch bricks from Lambs to be redelivered
Grille/ ducts behind hit and miss brickwork GFL plantroom- deviation from CVA/ MFLLP intent/ comments- HCL to advise
Ditto
Fireline underway to AS plantroom
Plastering underway to AS lobby GFL
Assembly Hall linings to main hall- corner fillets complete
Assembly gables nearing completion
Friday, 19 November 2010
101118 Site Visit
Assembly Hall GL 18 brickwork- gables now complete- awaiting Fireborn capping
Ditto
Decorative brickwork infill panel GL D/3 nears completion
1fl TEK vents delivered/ installation underway
TEK sill incorrect angle- TEK addressing and re-manufacturing/ fitting
Ditto
Containment/ fixing of cable tbc with MFLLP
Reveals to rooflights- Otway loft internal
Recessed lights to stairwell- Otway
beading details to Otway loft- awaiting plaster skim
Assembly lining underway- corner fillets to be completed. Vales/ Taylor engineering to confirm details for hanging fixings to raked internal lining GL P-Q
Hairline crack to brick horizontally over Ancon brickwork support GL 14- HRW to advise
Special bricks glued to lintol GL 18. HCL to forward tech specs/ method- still outstanding
Corner/ parapet GL Q/18. Timber/ insulation installation underway. DGT gutter to be cute down. Parapet awaiting Capping.
Ibstock Fireborn cappings now on site.
Gable detail GL 9- clearance acceptable
Inadequate clearance to brick upstand GL 1
Ditto

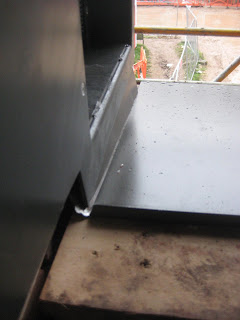

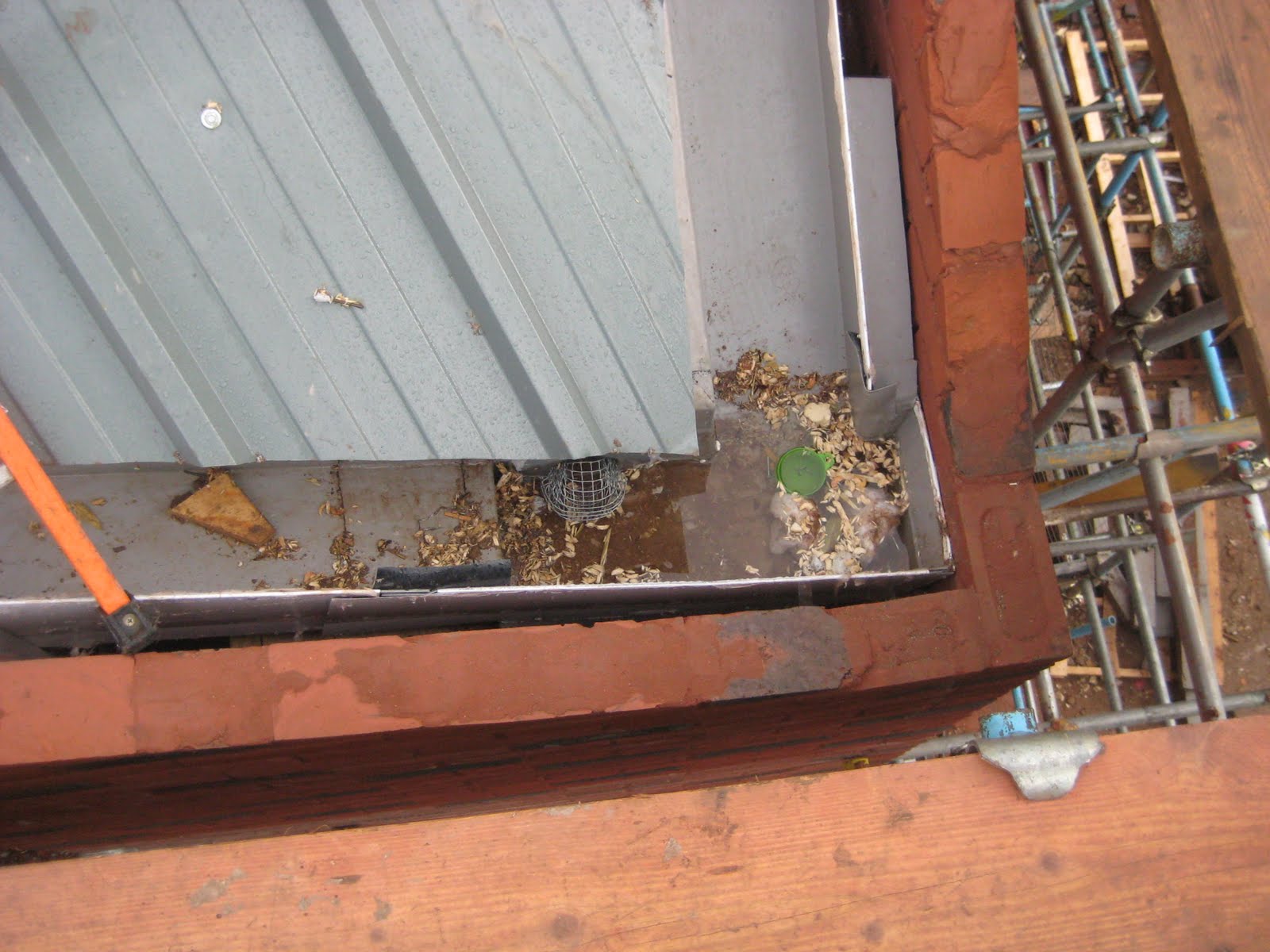

Gutter lower than outlet position- GL D/4
GL D/1- outlet finishing poor- HCL to advise
Ditto
Ditto
Internal gutter level to be lowered to parapet level- HCL to advise
Ditto
Edge detail poorly cut- HCL to advise
Hip detail refitted but GRP detail still tbc- HCL to advise
Outlet/ falls to valley gutter inadequate- HCL to advise
Detail/ intent not as CVA DWG CL330 PL01 + notes.- HCL to advise
