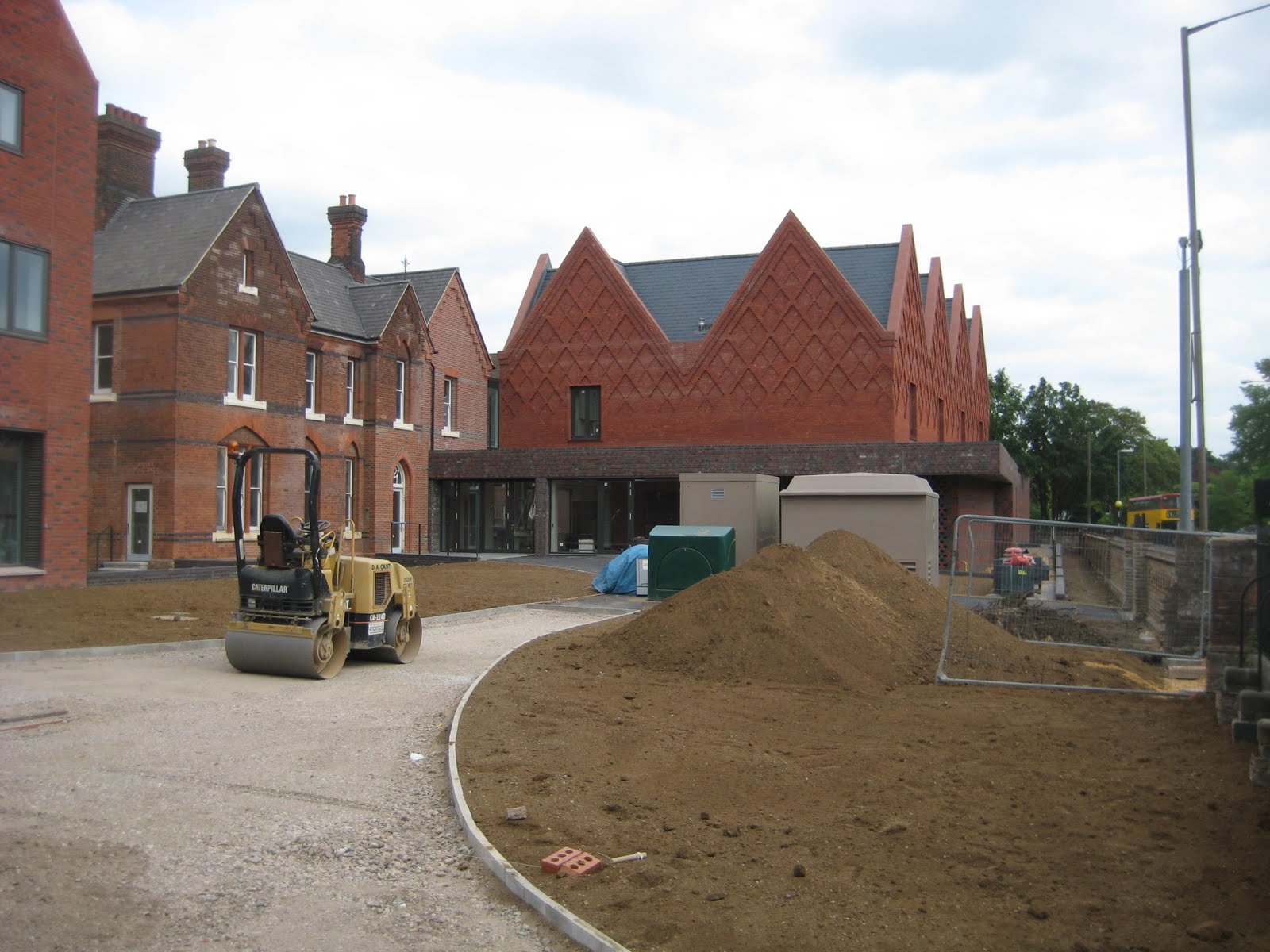

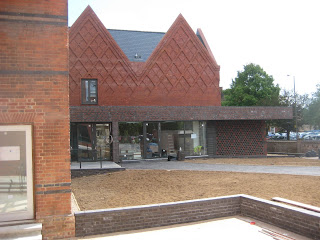

Friday, 20 May 2011
110519 Site Visit
Footings to courtyard landscape walls
Cleaning to classroom brickwork still required
Classroom ground floor snagging
Assembly stair- handrail installation
CVA condemn Otway/ Assembly Junckers floor transition- 10mm discrepancy. HCL to now address
Otway perimeter landscape walls underway
Damp patch to Otway wall- not improving.
CL stair 1
Brick lights- issue regarding size- CVA to liaise with MFLLP regarding spec.
CL stair 1 soffit/ trim installed
Stair 2 nearing completion- final lacquer required
Gates to Ingrave Road re-installed
Soft landscape works ongoing to Ingrave Road side
Air test underway assembly hall
Praeposters/ tile transitions general to be address
Lean-to greenhouse removed

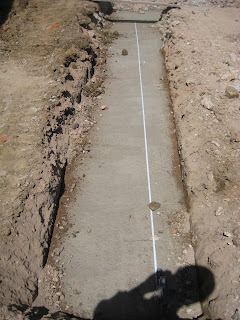

footings adjacent Queens
Greenhouse slab poured

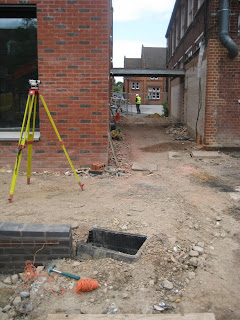

Draw pit to be repositioned- current conflict with hard/ soft landscape transitions
Courtyard landscape underway- levels raised
Brickwork to be cleaned- classroom block
Landscape- courtyard
Gas pipes- CVA to check with MFLLP whether these can be grey as currently conspicuous
Soft landscape Ingrave Road
Otway/ Assembly overview
Landscape lighting- base to go on base course- top fitting to be masked to maintain access when final coat (resin-bound) is applied
Assembly green room lighting does not match specified fitting- HCL to advise
Monday, 16 May 2011
110512+13 Site Visit
Ingrave Road overview: Landscape base course laid/ kerbs installed
AS- harbo panelling installed- spindles for Salto too short- consult AC Leigh
AS- acoustic panel frames decorated
AS- stair nosing detail/ inset tread
AS- stair overview
CL- handrail to stair 2 underway- sweeping bends resolved
CL- stair 1- handrail completed- awaiting lacquer
CL- matwell installed
OT- perimeter landscape wall underway
CL- stair 1- infill panel to acoustic ceiling required GFL
Otway stair- lighting installed/ decs almost complete
CL- stair 1- alternative escape light required- CVA/ MFLLP to discuss
OT/AS- discrepancy in floor finish levels in transition- HCL to advise/ propose solution
Otway arch- 2 No. repairs required
AS- plinth landscape capping complete- awaiting block pavers/ manholes
ditto
AS- soft landscape to perimeter underway
Minor additional repointing required to Ingrave Road wall
Tree stumps- to be grubbed/ removed
AS- awaiting soffit panels
Praeposters court- hard landscape complete- Otway door decoration required
GEN: Window linings generally require rub down/ redec.
GFL classroom 1- grilles installed- making good/ redec required
CL stair panels installed Stair
Green room- flashing required for return glazing
AS plant room- repair to damaged brickwork required
AS_ plinth completed- awaiting resin bound gravel final coat
PR- courtyard landscape footings underway
